Define dependencies between Tasks - Table

In the table view, there are various options for defining dependencies between tasks.

FS relationship:

➢Select the task to which you want to assign a predecessor (e.g. Subtask 2).

➢Double-click in the cell in the Predecessor column. (1)

➢Click on the down arrow. ▶ The drop-down menu opens.

➢In the drop-down menu, click on the task that you want to define as the predecessor (e.g. Subtask 1). (2)

➢Click outside the menu to exit.

➢The two tasks are linked with a finish-to-start relationship.

▶ Subtask 2 only starts when subtask 1 has been completed.

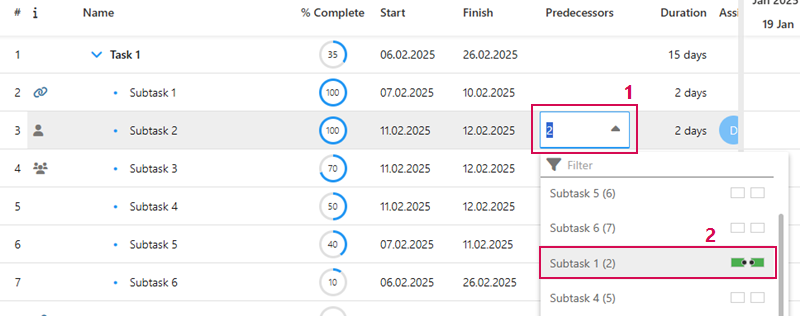

EN-FSRelationshipTable_1

Or

➢Enter the number of the task to be assigned as the predecessor in the Predecessor column.

EN-FSRelationshipTable_2



Define SS, FF and SF relationship:

To define the other dependencies, proceed as follows:

➢Select the task to which you want to assign a dependency to another task.

➢Double-click in the Predecessor column.

➢Enter the number of the operation that you want to relate to the current task and enter the dependency SS, FF or SF.

▶ The two tasks are linked to the desired dependency.

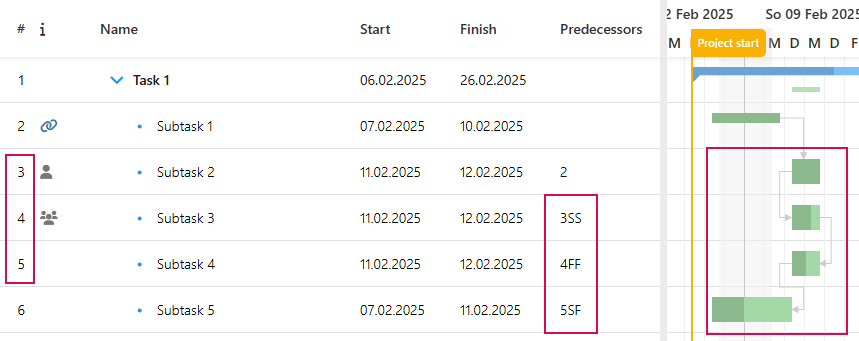

EN-OtherDependenciesTable_1

▶ Alternatively, you can show the Successor column and define the subsequent task as described above.
