Define dependencies between Tasks - Table

In the table view, there are various options for defining dependencies between tasks.

FS relationship:

Select the task to which you want to assign a predecessor (e.g. Subtask 2).

Double-click in the cell in the Predecessor column. (1)

Click on the down arrow. The drop-down menu opens.

In the drop-down menu, click on the task that you want to define as the predecessor (e.g. Subtask 1). (2)

Click outside the menu to exit.

The two tasks are linked with a finish-to-start relationship.

Subtask 2 only starts when subtask 1 has been completed.

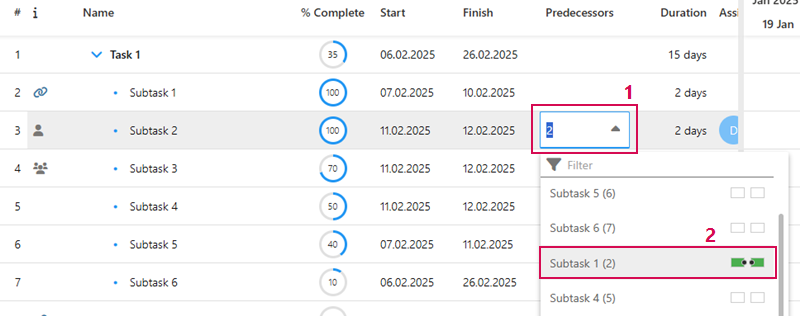

EN-FSRelationshipTable_1

Or

Enter the number of the task to be assigned as the predecessor in the Predecessor column.

EN-FSRelationshipTable_2



Define SS, FF and SF relationship:

To define the other dependencies, proceed as follows:

Select the task to which you want to assign a dependency to another task.

Double-click in the Predecessor column.

Enter the number of the operation that you want to relate to the current task and enter the dependency SS, FF or SF.

The two tasks are linked to the desired dependency.

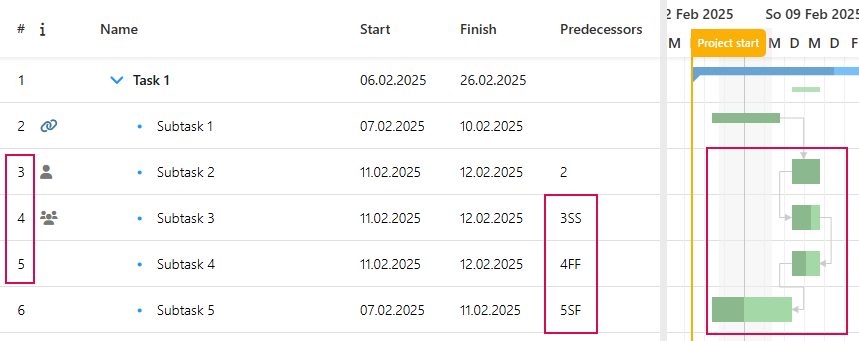

EN-OtherDependenciesTable_1

Alternatively, you can show the Successor column and define the subsequent task as described above.
